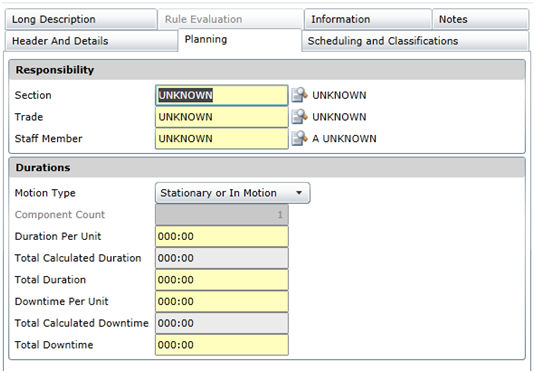

Task - Planning tab


Data fields

These data fields are captured or displayed on the Asset Type Task - Planning tab or the Asset Task - Planning tab.

Field

Description/Setting

Responsibility



Section

Defaults to “UNKNOWN”.

Select the responsible Section from the lookup list of all Sections.

Trade

Defaults to “UNKNOWN”.

Select the responsible Trade from the lookup list of all Trades.

If a Trade is not selected and a Labour record is added for or linked to an Asset Task then Trade defaults to the Trade that is specified for the Labour record.

Staff Member

Defaults to “UNKNOWN”.

Select the responsible Staff Member from the lookup list of all Staff Members.

Durations (in Hours:Minutes)

Motion Type

Identifies whether the Asset must be moving or stationary when the Asset Task is executed.

Possible values are “Stationary', “In Motion” or “Irrespective”.

Select a Motion Type that minimises downtime, always bearing in mind safety.

Component Count

The number of Component units is displayed.

Defaults to the Quantity specified for the Component, or defaults to “0” of the Task is added to an Asset Type or Asset.

Duration per Unit

The time required for each Trade to complete this Task on one Component unit.

Calculated as å[Labour Duration required for each Trade] if Labour is specified for the Task.

For example, 00:30 to replace one gear.

Total Calculated Duration

Calculated as [Component Count x Duration per Unit].

The system assumes that the Component Count is “1” when the default value is “0”.

Downtime per Unit

The planned time that the Component unit will not operate while work is performed.
For example, 00:15 standing time is allowed to prepare the Component unit for maintenance.

If the Component unit can operate while the Task is executed then Downtime is 00:00.

Total Calculated Downtime

Calculated as [Component Count x Downtime per Unit]

Total Downtime

Total Calculated Downtime plus the planned time that the Asset will not be running before and/or after work is performed. For example, 00:15 standing time is allowed to prepare the Asset for maintenance.

If the Asset can be running while the Task is performed then Downtime is 00:00.

Please note!
